Introduction

Team $100K MRR: Nathan Lodge and Slater Leonardo.

This book is the project wiki: status reports, Gantt, presentations, specs, and how to log in or deploy. The live site is emotial.app.

Use the sidebar. Planning is the first 10 weeks (proposal, diagrams, wireframes). Implementation is the coding quarter.

Intro to Senior Project

The first 10 weeks: proposal, diagrams, wireframes, and Gantt. There is no week 10 status report.

Week 1 is the proposal. Status reports start at week 2.

$100K MRR - Project Proposal (Planning Week 1)

Team Name

$100K MRR

Team Members

  • Nathan Lodge
  • Slater Leonardo

Business Opportunity / Problem

Social Media Web Application

Users

Our users will be anyone who is interested in using a social media site to stay social. In reality, it will be mostly NEIT students.

User Requirements

Non-Logged-In Users

  • View Posts
  • View Timeline
  • Advanced Timeline Management
    • Sort Timeline
    • Filter Timeline
    • Search Posts
  • View Profiles
  • Sign up
  • Log in
  • Reset Password (maybe, if we choose to use Resend for sending emails)
  • Change Website Theme

Users

  • Post Management
    • React to Post
    • Create Post
    • Edit Post
    • Delete Post
    • Share Post
    • Reply to Post
    • Add an Image to a post (up to 4)
    • Add animated images (gifs)
    • Video uploading (max 1)
    • Rich Post Functionality
      • Mentioning
      • Hashtags
      • Reaction List
  • Other Users Management
    • Follow User
    • View Other User's Followers
  • Profile Management
    • Add Profile Picture
    • Animated Profile Pictures (gifs)
    • Add Banner
    • Update Bio
    • Update Username / Display Name
    • Update Password
  • Notifications
    • Get notified when another user reacts to your post
    • Get notified when another user follows you
    • Get notified when another user replies to your post
  • Live Events
    • Real-time notifications via WebSockets
  • Developer Tools
    • Ability to create a bot
    • API access for programmatic interaction
  • Profile Badges
    • Admin Badge
    • Follower Badges: 10+, 25+, 100+

Admins

  • View All Profiles
  • View Reports
  • Delete Accounts
  • Delete Posts

Technology Stack

Frontend

  • Next.js / React
  • Tailwind CSS
  • TypeScript
  • Socket.io Client

Backend

  • Golang
  • Gin
  • Gorm
  • Socket.io

Infrastructure

  • PostgreSQL
  • Docker
  • Minio S3 (maybe, for image blob storage)

Services

  • GitHub
  • Cloudflare
  • Resend (maybe, for emails)
  • Google (maybe, for Google OAuth logins)

High Level Database Architecture

  • Users
  • Posts
  • Notifications
  • Relationships (Followers / Following)
  • Reactions (our version of Likes)
  • Shares
  • Reports

$100K MRR - Status Report: Planning Week 2

Project Summary

Emotial is a social media platform with a unique emoji reaction system, videos, animated profile pictures, and more.

Team Members

MemberHours This Week
Nathan Lodge1
Slater Leonardo1

Completed Tasks

TaskOwner
Completed project proposalBoth

Time Tracking

PlannedActualRemaining Budget
Hours11

Planned Tasks for Next Week

TaskOwner
Start designing a mockup for the prototype due Week 4Both
Complete use cases diagramBoth

Project Risks

RiskSeverity (High / Medium / Low)
Time management with workMedium
Easter holidayMedium

Overdue Tasks

  • N/A

Issues

  • Running out of time to design prototype.

Follow-up Actions

ActionResponsible Person
Finalize what the social media platform is going to look likeBoth
If prototype isn't done by Week 4, continue working on itBoth

$100K MRR - Status Report: Planning Week 3

Project Summary

Emotial is a social media platform with a unique emoji reaction system, videos, animated profile pictures, and more.

Team Members

MemberHours This Week
Nathan Lodge5
Slater Leonardo5

Completed Tasks

TaskOwner
Use cases diagramBoth
Started wireframeNathan

Time Tracking

PlannedActualRemaining Budget
Use cases diagram1 hr1 hr
WireframeN/A4 hrs

Planned Tasks for Next Week

TaskOwner
Continue wireframeNathan

Project Risks

RiskSeverity (High / Medium / Low)
Gantt chartMedium
WireframeLow
Database designLow

Overdue Tasks

  • N/A

Issues

  • N/A

Follow-up Actions

ActionResponsible Person
Continue wireframeNathan
Start Gantt chartBoth

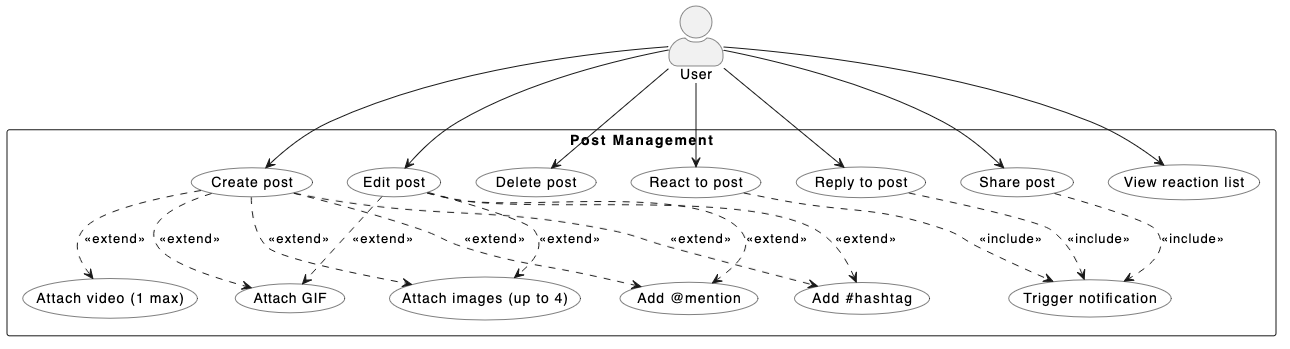

Use Cases

Overview

Post Management

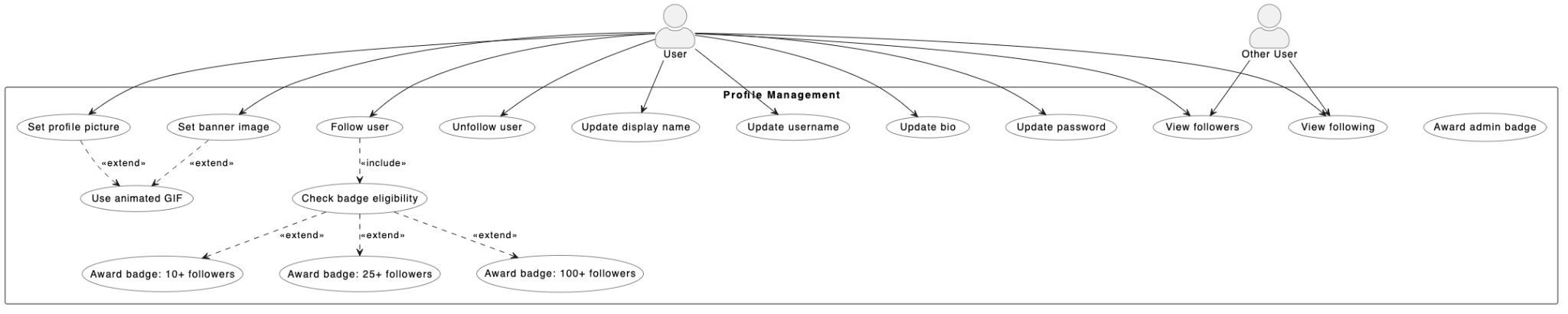

Profile Management

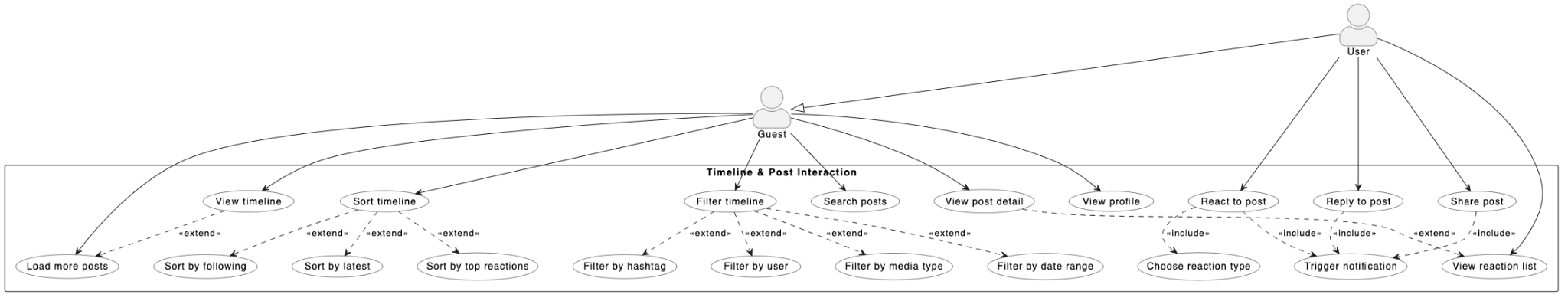

Timeline

$100K MRR - Status Report: Planning Week 4

Project Summary

Emotial is a social media platform with a unique emoji reaction system, videos, animated profile pictures, and more.

Team Members

MemberHours This Week
Nathan Lodge10
Slater Leonardo5

Completed Tasks

TaskOwner
Start wireframeNathan
Start 10-week Gantt chartNathan

Time Tracking

PlannedActualRemaining Budget
Hours1010

Planned Tasks for Next Week

TaskOwner
Complete midterm presentationNathan
Complete ERDSlater

Project Risks

RiskSeverity (High / Medium / Low)
Time management with workMedium
Slater's sister's birthdayLow

Overdue Tasks

  • N/A

Issues

  • N/A

Follow-up Actions

ActionResponsible Person
Continue wireframeNathan
Database design / ERDSlater

Prototype

Feed

Explore

Notifications

Profile

Settings

$100K MRR - Status Report: Planning Week 5

Project Summary

Emotial is a social media platform with a unique emoji reaction system, videos, animated profile pictures, and more.

Team Members

MemberHours This Week
Nathan Lodge7
Slater Leonardo10

Completed Tasks

TaskOwner
Frontend wireframe and Gantt chartNathan Lodge
ERD and database designSlater Leonardo

Time Tracking

PlannedActualRemaining Budget
Hours20173

Planned Tasks for Next Week

TaskOwner
Activity diagramBoth

Project Risks

RiskSeverity (High / Medium / Low)
Time managementLow

Overdue Tasks

  • N/A

Issues

  • N/A

Follow-up Actions

ActionResponsible Person
Continue work on wikiBoth

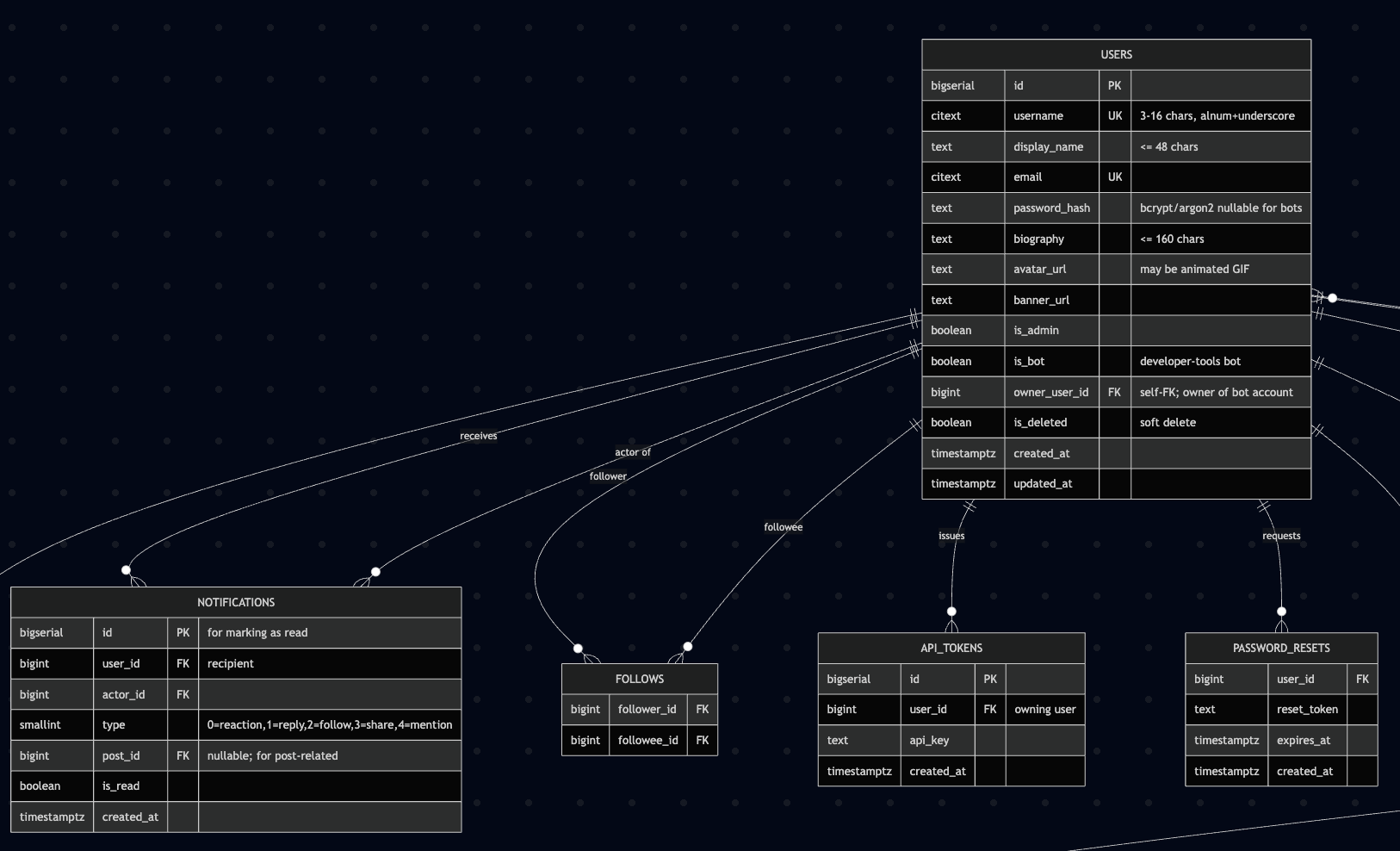

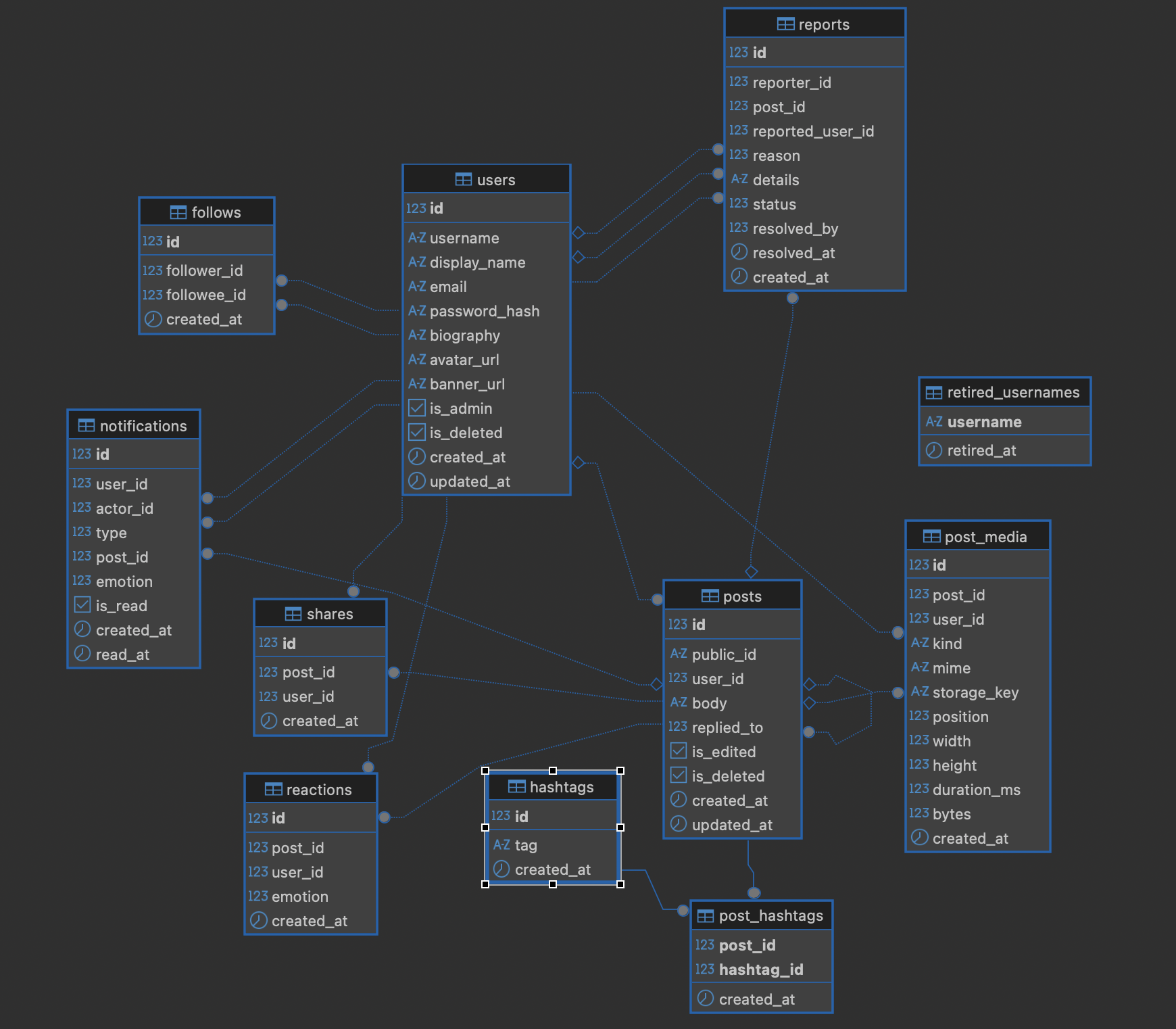

Entity Relationship Diagram

697

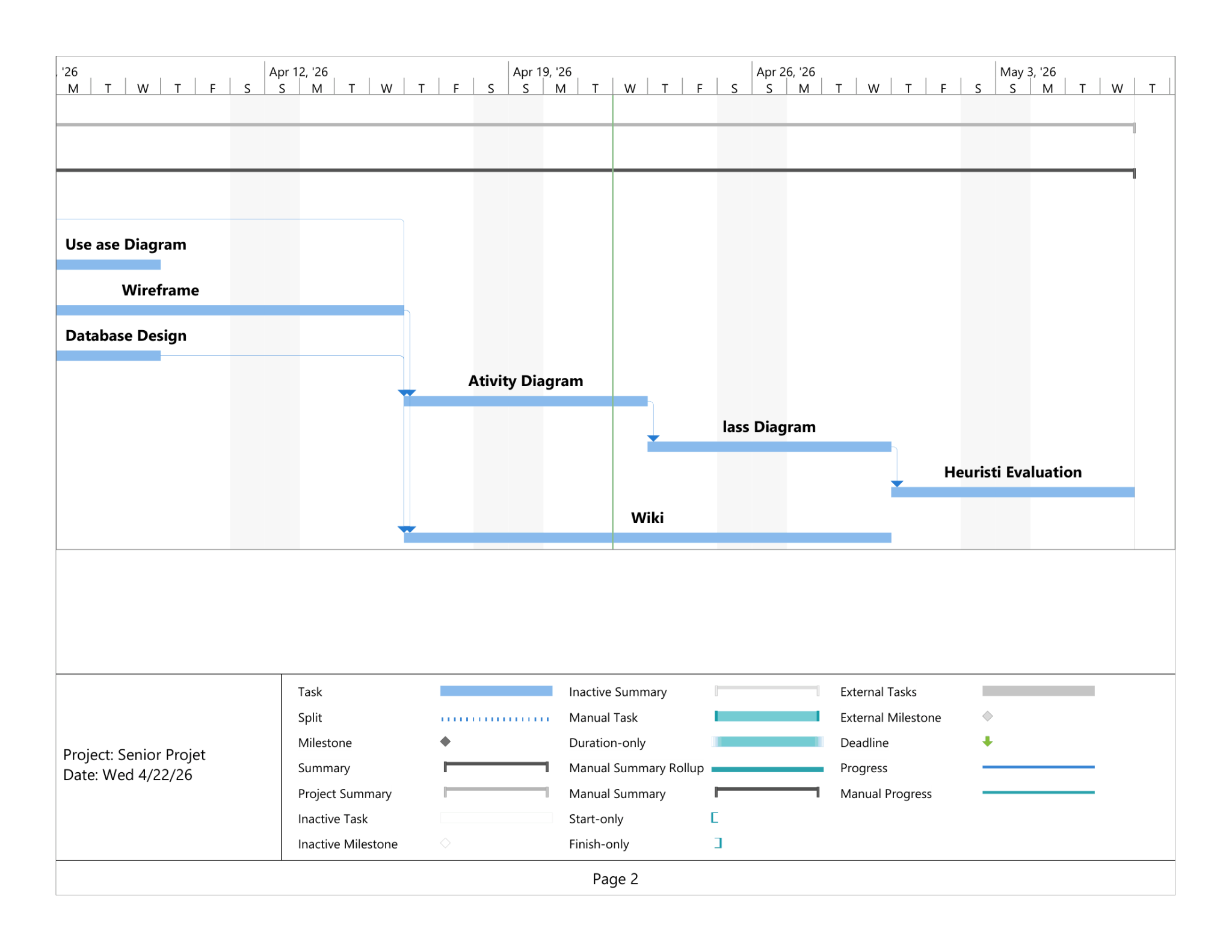

Gantt Chart

$100K MRR - Status Report: Planning Week 6

Project Summary

Emotial is a social media platform with a unique emoji reaction system, videos, animated profile pictures, and more.

Team Members

MemberHours This Week
Nathan Lodge2
Slater Leonardo5

Completed Tasks

TaskOwner
Activity diagramSlater
Continue designNathan

Time Tracking

PlannedActualRemaining Budget
Hours

Planned Tasks for Next Week

TaskOwner
Class diagramsBoth

Project Risks

RiskSeverity (High / Medium / Low)
Family health issuesMedium
Nathan's work scheduleMedium

Overdue Tasks

  • N/A

Issues

  • N/A

Follow-up Actions

ActionResponsible Person
N/A

Activity Diagrams

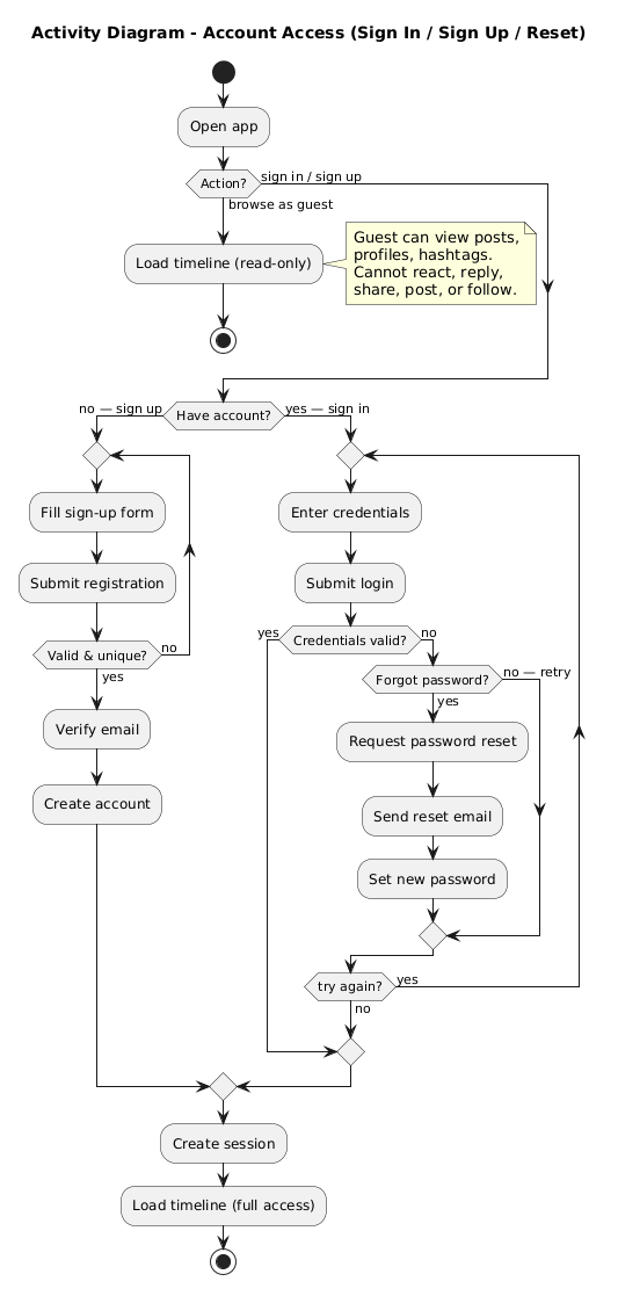

Account Access

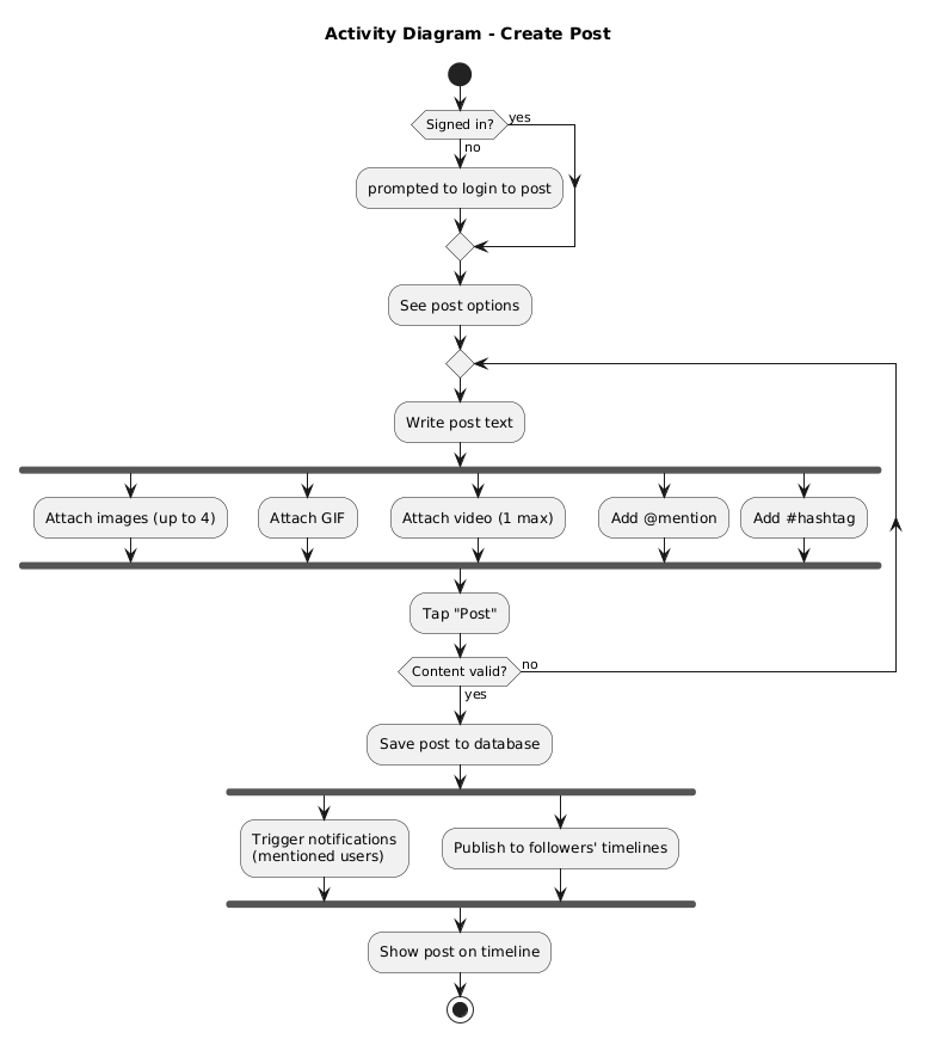

Create Post

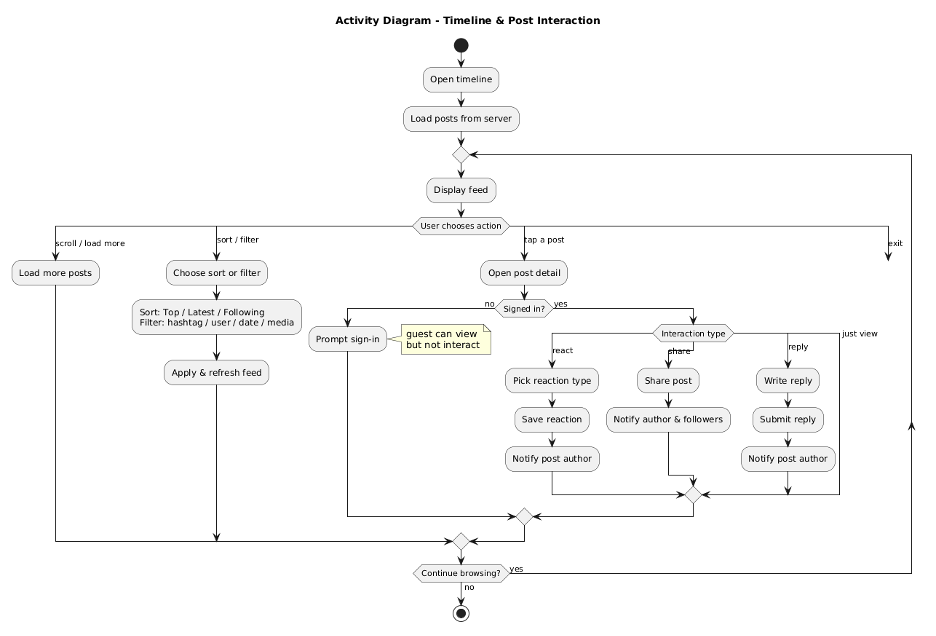

Timeline & Post Interaction

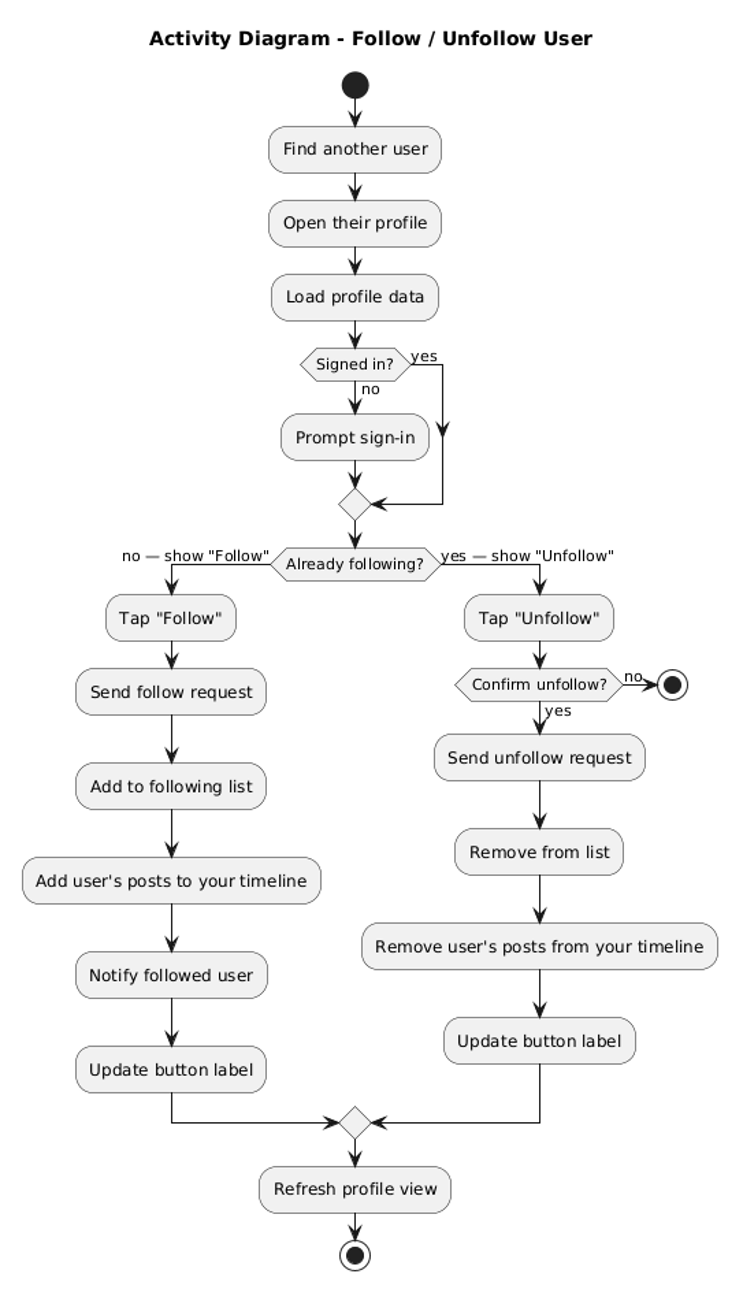

Follow / Unfollow User

$100K MRR - Status Report: Planning Week 7

Project Summary

Emotial is a social media platform with a unique emoji reaction system, videos, animated profile pictures, and more.

Team Members

MemberHours This Week
Nathan Lodge3
Slater Leonardo3

Completed Tasks

TaskOwner
Class diagramBoth
Keep experimenting with wikiBoth

Time Tracking

PlannedActualRemaining Budget
Hours

Planned Tasks for Next Week

TaskOwner
Heuristic evaluationBoth
Improve designBoth

Project Risks

RiskSeverity (High / Medium / Low)
Family health issuesMedium
Time managementMedium

Overdue Tasks

  • N/A

Issues

  • N/A

Follow-up Actions

ActionResponsible Person
N/A

Class Diagram

697

$100K MRR - Status Report: Planning Week 8

Project Summary

Emotial is a social media platform with a unique emoji reaction system, videos, animated profile pictures, and more.

Team Members

MemberHours This Week
Nathan Lodge3
Slater Leonardo2

Completed Tasks

TaskOwner
Heuristic evaluationNathan Lodge
Heuristic evaluationSlater Leonardo

Time Tracking

PlannedActualRemaining Budget
Hours1053

Planned Tasks for Next Week

TaskOwner
Activity diagramBoth

Project Risks

RiskSeverity (High / Medium / Low)
Time managementLow

Overdue Tasks

  • N/A

Issues

  • N/A

Follow-up Actions

ActionResponsible Person
N/A

Heuristic Evaluation

1. Visibility of system status

The sidebar will have the current page you're on highlighted and when actions are performing liked creating a post or editing your account settings, navigation and text displayed will allow users to understand where they are and that their actions went through.

2. Match between system and the real world

The site already looks like common social media sites and has common symbols users like recognize like a magnifying glass for searching, house for home page, etc. Additionally, one of the core features of emotial are the emoji reactions which are meant to mirror real reactions people have.

3. User control and freedom

Users will be able to sign out, delete their accounts, edit their posts, unreact to posts, unfollow a profile, etc. All of these are examples of a user being able to reverse their actions.

4. Consistency and standards

Many pages will reuse the same shared layout (navigation on the left, content in the middle, friends/trending content on the right) which is coherent. Also, typography and common cards will be built so that the app has a uniform look.

5. Error prevention

On forms like login and signup there will be danger borders and labels showing validation errors, there will able be zero states for example on search showing that their search returned no results so that users are always in the loop.

6. Recognition rather than recall

There are explicit buttons/labels for actions that may not be obvious and common elements have common interactions across pages. This will make it easy for users to recognize how to interact with elements.

7. Flexibility and efficiency of use

The timeline and profiles will work well for both writing posts and browsing/reading posts. There will also be power user options like sorting by reaction and options like that. This adds flexibility to what users can do while meeting everyones needs.

8. Aesthetic and minimalist design

Emotial has a simple but consistent and explicit user interface. There are buttons for common operations and dropdown menus for more complex operations. The typography is consistent across components and is easy on the eyes.

9. Help users recognize, diagnose, and recover from errors

There was be clear danger borders and labels showing when an error has occurred. for example, invalid password or post text is too long. One really important one is file size too big for images/videos. If they silently fail to upload with no visual indicator that is bad.

10. Help and documentation

There's no documentation or help section yet, but we plan on having a sort of onboarding modal appear when you login for the first time that shows the common actions users can perform. Maybe we will add a support button / help section at some point too.

$100K MRR - Status Report: Planning Week 9

Project Summary

Emotial is a social media platform with a unique emoji reaction system, videos, animated profile pictures, and more.

Team Members

MemberHours This Week
Nathan Lodge5
Slater Leonardo5

Completed Tasks

TaskOwner
Final WikiBoth
Final Gantt chartBoth

Time Tracking

PlannedActualRemaining Budget
Hours10

Planned Tasks for Next Week

TaskOwner
Final PresentationBoth

Project Risks

RiskSeverity (High / Medium / Low)
Time management with other finalsMedium

Overdue Tasks

  • N/A

Issues

  • N/A

Follow-up Actions

ActionResponsible Person

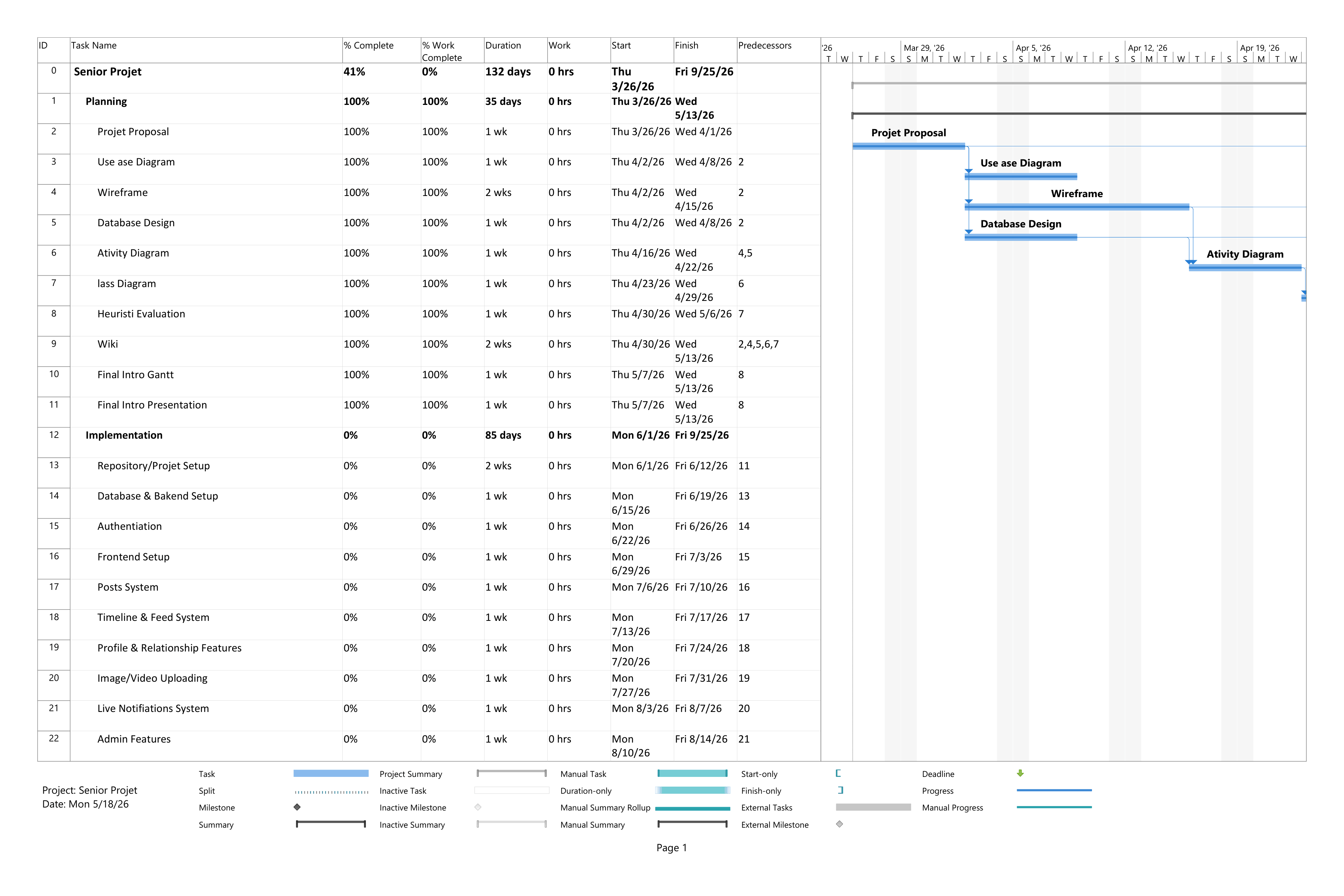

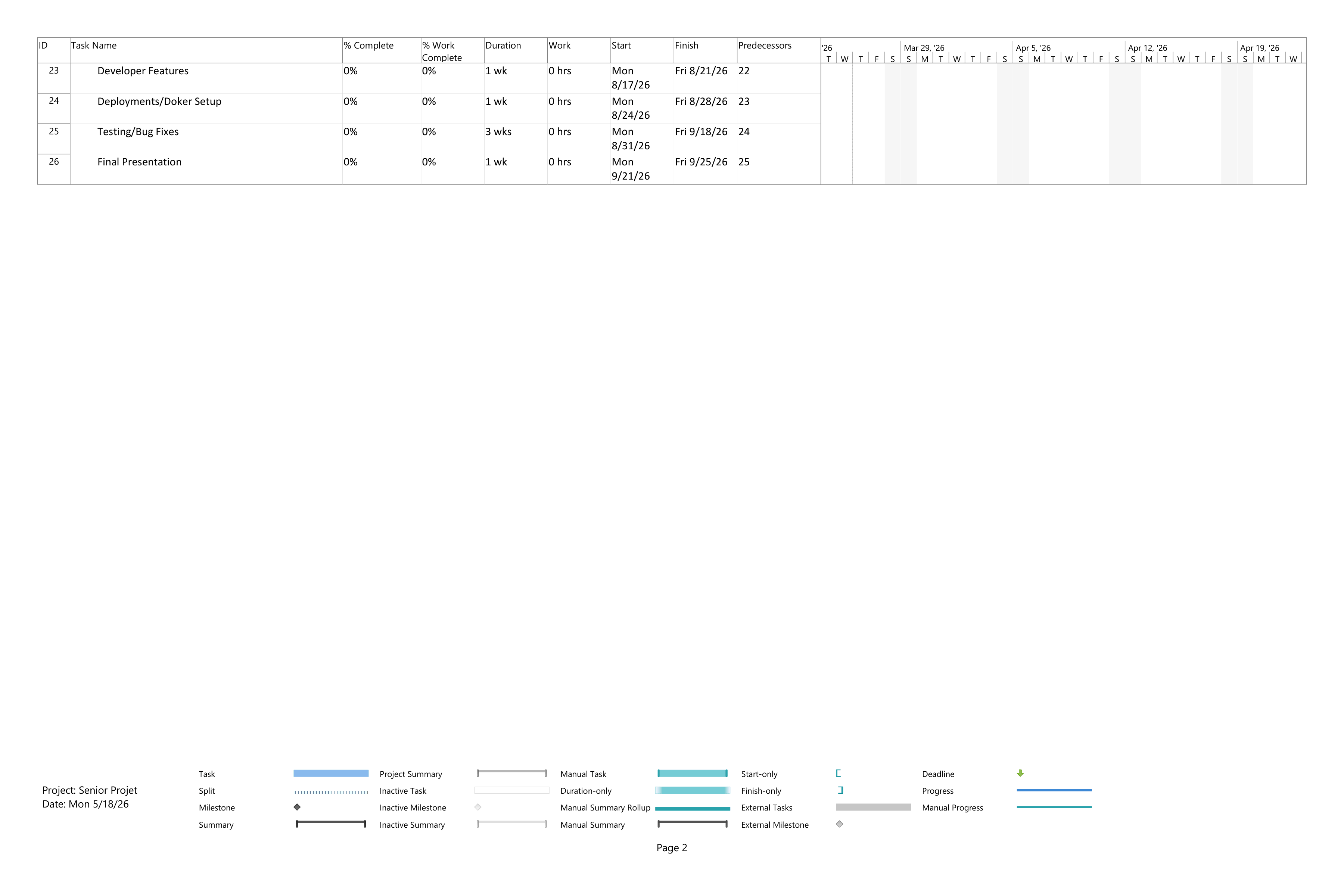

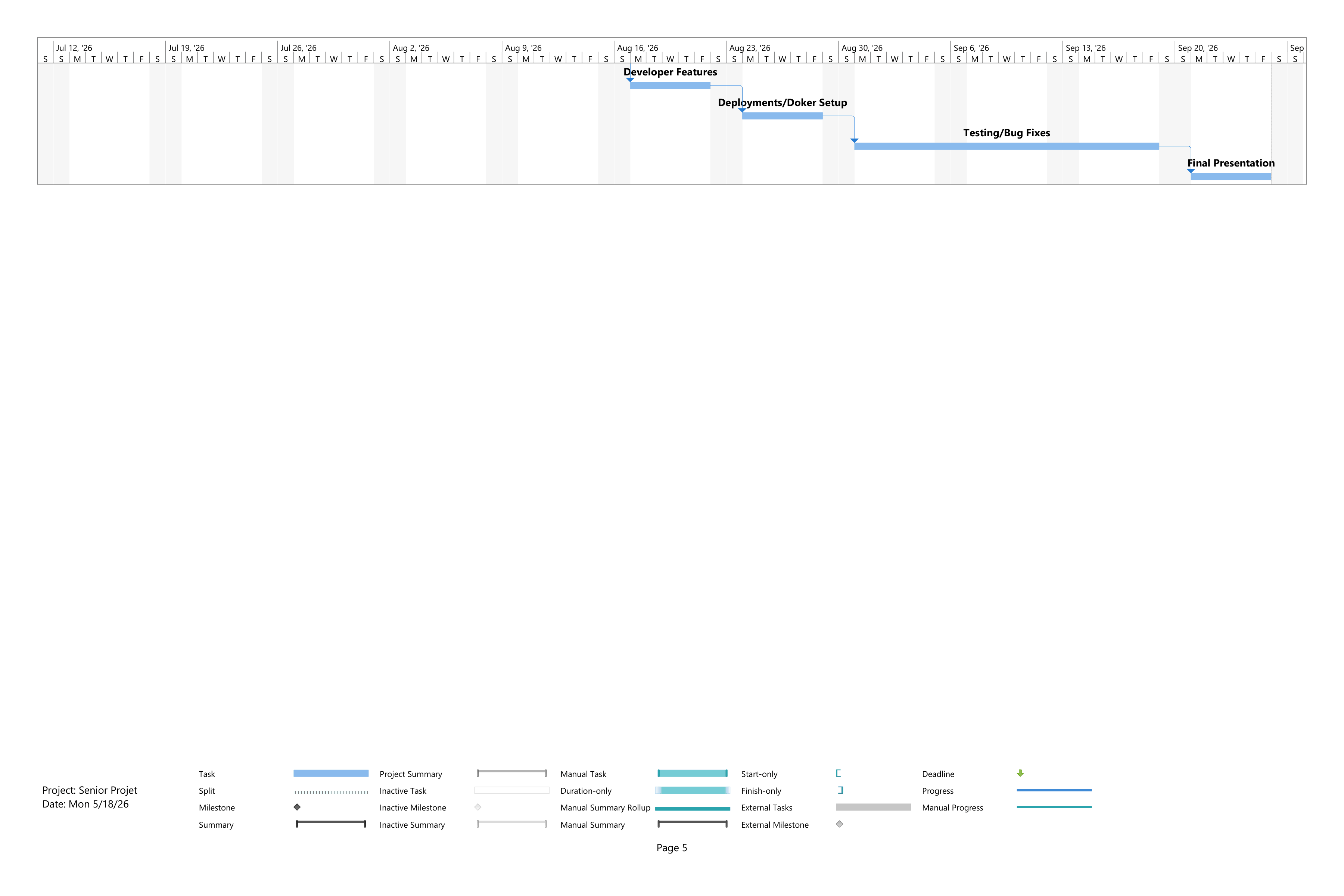

Gantt Chart

Senior Project

The next 10 weeks: building and shipping Emotial. There are no week 1 or week 10 status reports.

The site went live at emotial.app in week 9.

$100K MRR - Status Report: Implementation Week 2

Project Summary

A social media site with a unique reactions system.

Team Members

MemberHours This Week
Nathan Lodge10
Slater Leonardo5

Completed Tasks

Task
Start mocking UI pages with React
Start API implementation

Time Tracking

PlannedActualRemaining Budget
Hours1515

Planned Tasks for Next Week

Task
Continue working on UI and API and getting ready to connect them
Set up development/staging database

Project Risks

RiskSeverity (High / Medium / Low)
Time managementMedium

Overdue Tasks

  • N/A

Issues

  • N/A

Follow-up Actions

ActionResponsible Person
N/A

$100K MRR - Status Report: Implementation Week 3

Project Summary

A social media site with a unique reactions system.

Team Members

MemberHours This Week
Nathan Lodge10
Slater Leonardo10

Completed Tasks

Task
Continue API implementation
Continue website implementation
Set up development PostgreSQL instance
Set up development Minio instance

Time Tracking

PlannedActualRemaining Budget
Hours2020

Planned Tasks for Next Week

Task
Continue working on API to get it ready to connect to frontend
Keep working on UI pages on frontend using a mock API

Project Risks

RiskSeverity (High / Medium / Low)
Time managementMedium

Overdue Tasks

  • N/A

Issues

  • N/A

Follow-up Actions

ActionResponsible Person
N/A

$100K MRR - Status Report: Implementation Week 4

Project Summary

A social media site with a unique reactions system.

Team Members

MemberHours This Week
Nathan Lodge15
Slater Leonardo10

Completed Tasks

Task
Continue API implementation
Continue website implementation
Advanced frontend features: image uploading, GIFs, banners, post modal, and more

Time Tracking

PlannedActualRemaining Budget
Hours2525

Planned Tasks for Next Week

Task
Continue working on API to get it ready to connect to frontend
Keep working on UI pages on frontend using a mock API

Project Risks

RiskSeverity (High / Medium / Low)
Time managementMedium

Overdue Tasks

  • N/A

Issues

  • N/A

Follow-up Actions

ActionResponsible Person
N/A

$100K MRR - Status Report: Implementation Week 5

Project Summary

A social media site with a unique reactions system.

Team Members

MemberHours This Week
Nathan Lodge10
Slater Leonardo15

Completed Tasks

Task
Continue API implementation
Continue website implementation
Lots of backend API/controller wiring
More frontend features: auth pages, emoji packs, and themes
Started wiring API with web app

Time Tracking

PlannedActualRemaining Budget
Hours2525

Planned Tasks for Next Week

Task
Continue improving backend/frontend features
Continue wiring API with web app

Project Risks

RiskSeverity (High / Medium / Low)
Time managementMedium
Nathan going on vacation for a weekMedium

Overdue Tasks

  • N/A

Issues

  • N/A

Follow-up Actions

ActionResponsible Person
N/A

$100K MRR - Status Report: Implementation Week 6

Project Summary

A social media site with a unique reactions system.

Team Members

MemberHours This Week
Nathan Lodge15
Slater Leonardo15

Completed Tasks

Task
Continue API implementation
Continue website implementation
Continue backend API/controller wiring
Lots of frontend polish to make the app feel nicer to use: preloaders, animations, etc.

Time Tracking

PlannedActualRemaining Budget
Hours3030

Planned Tasks for Next Week

Task
Continue improving backend/frontend features
Continue wiring API with web app
Continue using/testing web app to make sure it feels nice to use, and polish what doesn't
Automated integration tests (Playwright)

Project Risks

RiskSeverity (High / Medium / Low)
Time managementMedium
Nathan going on vacation for a weekMedium

Overdue Tasks

  • N/A

Issues

  • N/A

Follow-up Actions

ActionResponsible Person
N/A

$100K MRR - Status Report: Implementation Week 7

Project Summary

A social media site with a unique reactions system.

Team Members

MemberHours This Week
Nathan Lodge15
Slater Leonardo15

Completed Tasks

Task
Continue API implementation
Continue website implementation
Continue backend API/controller wiring
Lots of frontend polish to make the app feel nicer to use: preloaders, animations, etc.

Time Tracking

PlannedActualRemaining Budget
Hours3030

Planned Tasks for Next Week

Task
Continue improving backend/frontend features
Continue wiring API with web app
Work on OpenAPI docs
Continue using/testing web app to make sure it feels nice to use, and polish what doesn't
Automated integration tests (Playwright)

Project Risks

RiskSeverity (High / Medium / Low)
Time managementMedium
Nathan going on vacation for a weekMedium

Overdue Tasks

  • N/A

Issues

  • N/A

Follow-up Actions

ActionResponsible Person
N/A

$100K MRR - Status Report: Implementation Week 8

Project Summary

A social media site with a unique reactions system.

Team Members

MemberHours This Week
Nathan Lodge20
Slater Leonardo15

Completed Tasks

Task
Continue API implementation
Continue website implementation
Continue backend API/controller wiring
Used feedback from Emotial beta testers to improve the web app
Working media uploads
Generated Open Graph images
Improved reactions system and replies system

Time Tracking

PlannedActualRemaining Budget
Hours3535

Planned Tasks for Next Week

Task
Continue improving backend/frontend features
Continue wiring API with web app
Continue using/testing web app to make sure it feels nice to use, and polish what doesn't

Project Risks

RiskSeverity (High / Medium / Low)
Time managementMedium
Other finalsMedium
Scope creepMedium

Overdue Tasks

  • N/A

Issues

  • N/A

Follow-up Actions

ActionResponsible Person
N/A

$100K MRR - Status Report: Implementation Week 9

Project Summary

A social media site with a unique reactions system.

Team Members

MemberHours This Week
Nathan Lodge15
Slater Leonardo15

Completed Tasks

Task
Continue API implementation
Continue website implementation
Continue backend API/controller wiring
Used feedback from Emotial beta testers to improve the web app
Live at https://emotial.app

Time Tracking

PlannedActualRemaining Budget
Hours3030

Planned Tasks for Next Week

Task
Continue using/testing web app to make sure it feels nice to use, and polish what doesn't
Final changes to get ready for presentation
Create presentation

Project Risks

RiskSeverity (High / Medium / Low)
Time managementMedium
Scope creepMedium

Overdue Tasks

  • N/A

Issues

  • N/A

Follow-up Actions

ActionResponsible Person
N/A

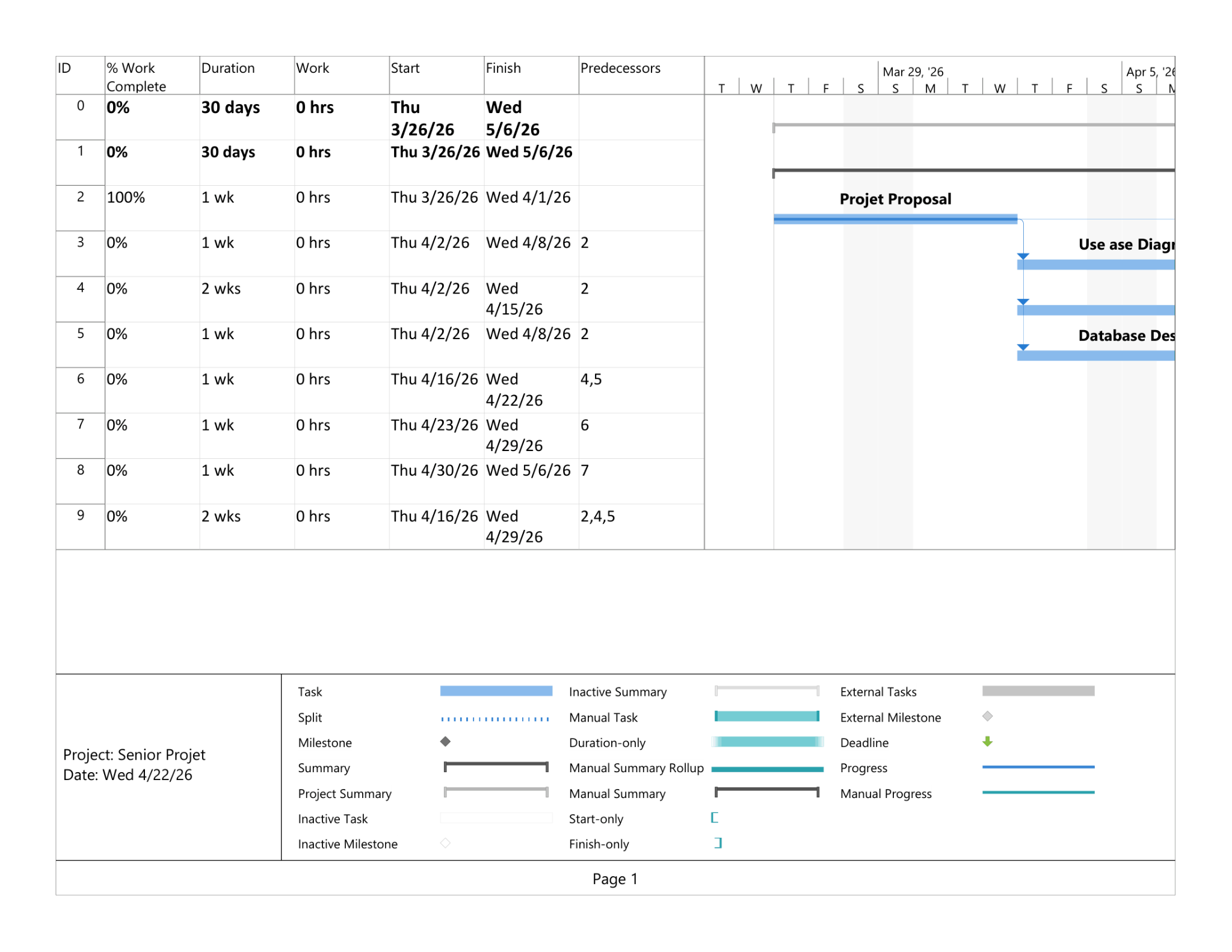

Gantt chart

This is the 20-week Gantt from the end of Intro to Senior Project (dated May 18, 2026). It covers both quarters: planning (March to May) and implementation (June to September). We did not make a second chart just for the coding quarter.

Planning tasks are marked complete. Implementation was still at 0% when we exported it, because that half was the plan for this quarter. Those tasks are done now, except the final presentation.

The midterm version from planning week 5 only covered the first quarter. That one is under Planning week 05.

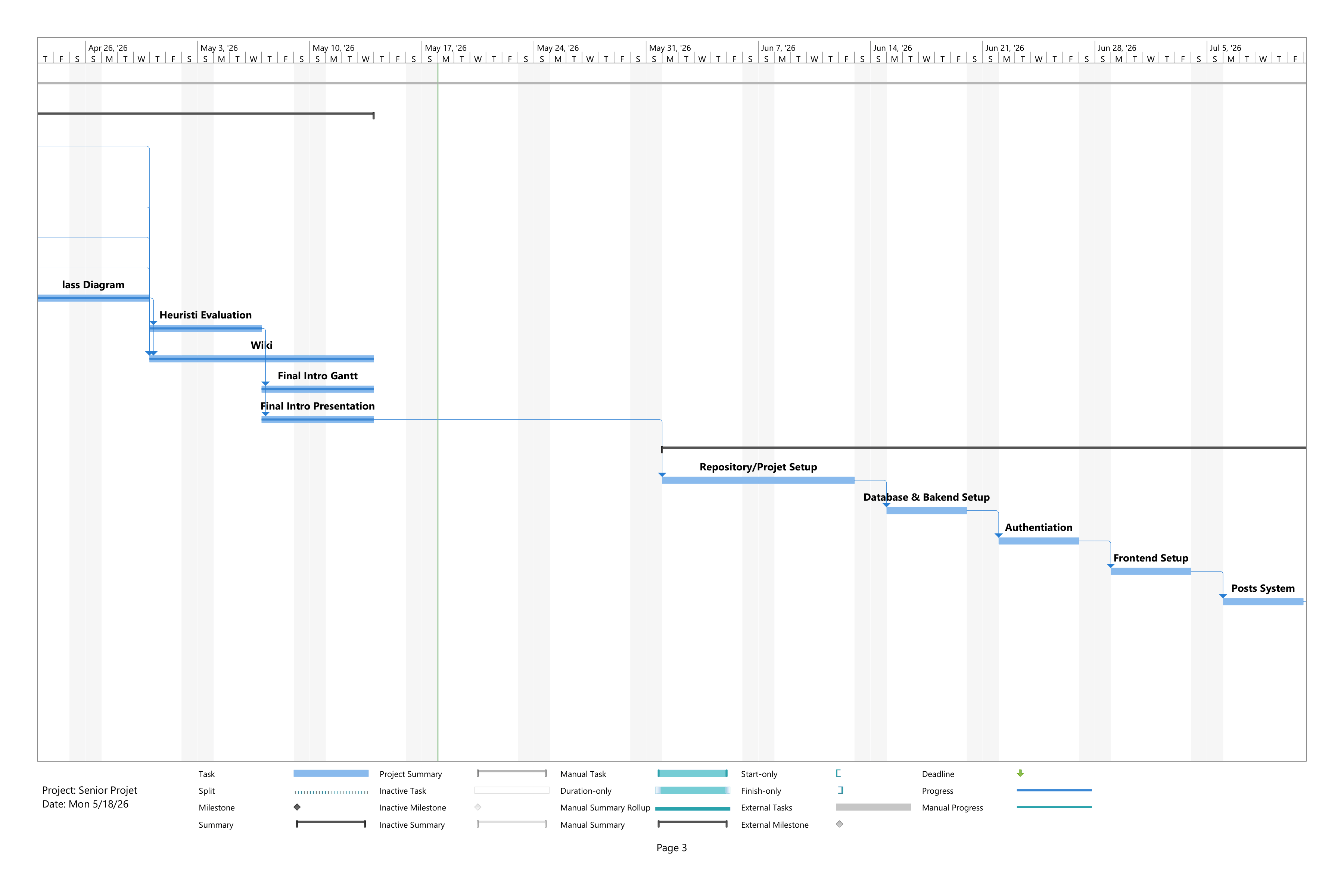

Full project (both quarters)

What the implementation bars were

Planned taskPlanned window
Repository / project setupJun 1 to 12
Database and backend setupJun 15 to 19
AuthenticationJun 22 to 26
Frontend setupJun 29 to Jul 3
Post systemJul 6 to 10
Timeline and feedJul 13 to 17
Profile and relationship featuresJul 20 to 24
Image / video uploadingJul 27 to 31
Live notificationsAug 3 to 7
Admin featuresAug 10 to 14
Developer featuresAug 17 to 21
Deployment / DockerAug 24 to 28
Testing / bug fixesAug 31 to Sep 18
Final presentationSep 21 to 25

Frontend and API work actually ran in parallel from implementation week 2, not in that strict order. The site went live at emotial.app in implementation week 9.

Midterm presentation (Intro to Senior Project)

Download the PowerPoint

Social Media Web Application

$100K MRR Team

Team members

Slater Leonardo

  • API
  • Database

Nathan Lodge

  • Frontend Developer
  • Designer

Project overview

This will be a full featured social media with a unique emoji reaction system.

Including everything you'd expect like:

  • User accounts
  • Posts (with images, GIFs, or a video)
  • Reactions
  • Replies
  • Sharing
  • Hashtags/mentions

It will also support extra features like realtime notifications, a developer bot API, and multiple themes to choose from.

Tech stack

Frontend

  • Next.js / React
  • Tailwind CSS
  • TypeScript
  • Socket.io Client

Backend

  • Golang
  • Gin (Go API Router)
  • Gorm (Go ORM)
  • Socket.io Server

Infrastructure

  • PostgreSQL
  • Docker
  • Minio S3 (Blob Storage)

Services

  • GitHub
  • Cloudflare
  • Google OAuth (maybe)

Gantt chart

Use case diagram

Post management

Profile management

Timeline

ERD: Account

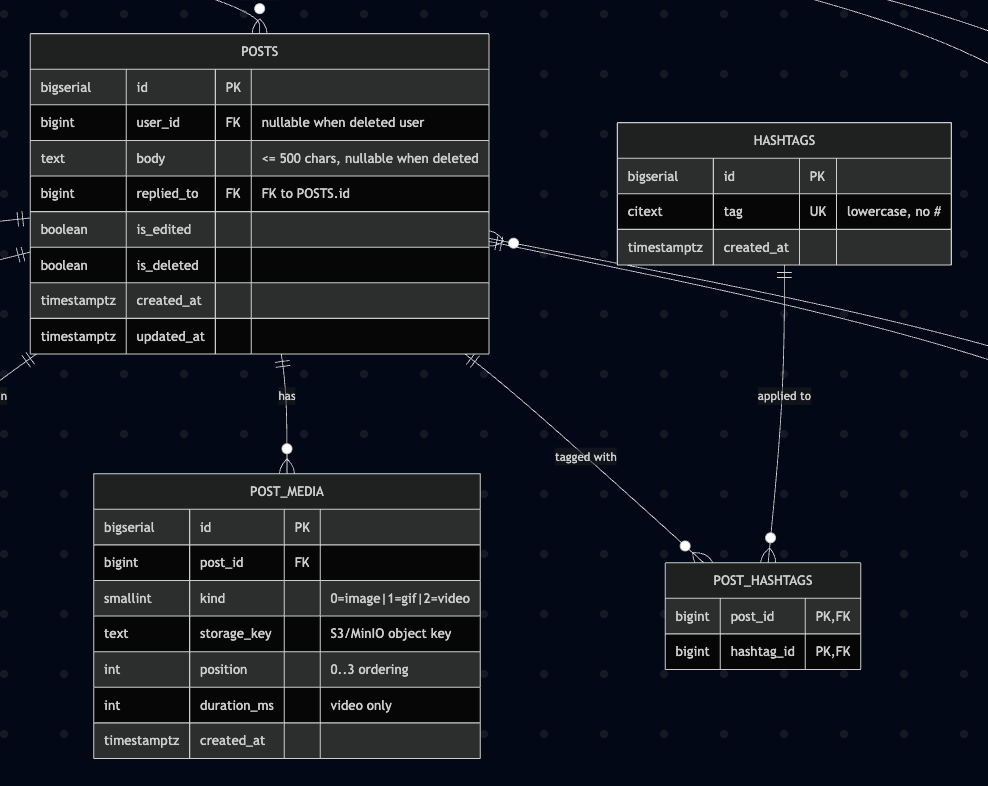

ERD: Posts

ERD: Admin

Wireframe (Feed)

Wireframe (Explore)

Wireframe (Notifications)

Wireframe (Profile)

Wireframe (Settings)

Final presentation (BS Capstone)

Download the PowerPoint

Team introduction

Nathan Lodge

  • Role: Frontend Developer, Designer, DevOps
  • Responsibilities: Design and build frontend, deploy app

Slater Leonardo

  • Role: Backend Developer, DB Admin
  • Responsibilities: Build API, design database

Emotial overview

The social platform for sharing your thoughts and feelings.

  • Full featured text-based social media
  • Unique emoji reaction system
  • User accounts
  • Avatars / banners
  • Following / friends
  • Posts (with images, GIFs, or a video)
  • Replies
  • Sharing
  • Hashtags / mentions
  • Realtime notifications
  • Multiple themes

Timeline

WeekHighlights
1Init frontend and backend, wired up boilerplate, set up hosting
2-3Profiles, avatars / banners / media, followers, search, live notifications, basic mobile layout
4Auth pages and login / signup, set up themes
5Frontend polish, Docker / CI, account settings, and media cropping
6Admin functionality, mentions / hashtags, emoji styles
7Shares, emoji picker, image uploading / CDN, Open Graph, reaction list
8Feed sorting, theme accents, friends / suggestions, drag-and-drop media
9Live new post updates, crop / zoom polish, and remaining bug fixes

Database ERD

Obstacles overcome

Frontend

  • Rich text editor with mentions, hashtags, and links
  • Media normalization / uploading in the background
  • Type safety between frontend and backend
  • Emoji styles

Backend

  • Creating an OpenAPI specification
  • Server-sent events
  • PostgreSQL on a large scale application

Technical design

Frontend

  • Next.js app with React client components fetching data via TanStack Query
  • API client generated from the backend's OpenAPI spec, keeping types in sync automatically
  • User interactions update the UI optimistically, then sync with the server in the background
  • Live feed and notification updates arrive over server-sent events

Backend

  • Go REST API built on Gin and Huma. Huma generates the OpenAPI spec from models and handlers
  • API handlers to service layer to GORM to Postgres
  • Auth with JWTs stored as a cookie
  • Live feed and notification updates are pushed over server-sent events

Deployments We deploy the app on one of Slater's servers. We use Docker to deploy frontend, backend, Postgres, and MinIO containers, which all connect over the local network.

Summary

Overall this project was fun for us. We had a lot of support and good ideas going in, so our focus was on executing and making the platform feel nice to use.

Live Demo

emotial.app

Sharing on Mobile

Open Graph

How to log in

Live site: https://emotial.app

You can browse the feed and profiles without an account. To post, react, follow, or reply, you need one.

Create an account

  1. Go to https://emotial.app/signup.
  2. Enter a display name (what people see on your profile).
  3. Enter a username (letters, numbers, and underscores only; 3-16 characters). It is stored lowercase.
  4. Enter an email.
  5. Enter a password (at least 8 characters).
  6. Click Create account.

You land on the feed, signed in. There is no email confirmation.

Log in later

  1. Go to https://emotial.app/login.
  2. Enter your email or username.
  3. Enter your password.
  4. Click Log in.

What to try

  • Feed (/): write a post, add images or a video, react with emoji, reply, share.
  • Explore (/explore): search posts and people.
  • Notifications (/notifications): follows, replies, and reactions on your posts.
  • Profile: open Profile in the sidebar to edit your avatar, banner, and bio.
  • Settings (/settings): email, password, theme.

To sign out, use Log Out in the sidebar.

How to deploy

Emotial runs as four Docker containers on one network: web, api, postgres, and minio. That is how production runs on Slater's server. The live site is https://emotial.app.

The Dockerfiles are source/web/Dockerfile and source/api/Dockerfile. source/docker-compose.yml starts all four.

What you need

  • Docker with Compose
  • About 4 GB of disk for the images

Start the stack

From submission/source/:

  1. Start Postgres and MinIO.
docker compose up -d postgres minio
  1. Apply the schema. The API connects to Postgres but does not create tables.
docker compose exec -T postgres psql -U emotial -d emotial -v ON_ERROR_STOP=1 < schema.sql
  1. Build and start the API and web app.
docker compose up -d --build api web
  1. Open http://localhost:3000. Create an account using the login instructions.
ServiceURL
Webhttp://localhost:3000
API healthhttp://localhost:8080/health
MinIO API (media)http://localhost:9000
MinIO consolehttp://localhost:9001

MinIO console: user emotial, password emotial-minio-secret. The API creates the emotial bucket when it starts.

Stop

docker compose down

Add -v if you want to delete the Postgres and MinIO volumes too.

How the containers talk

The browser loads the web app on port 3000 and calls the API on port 8080.

The API reaches Postgres as hostname postgres and MinIO as minio:9000.

Browsers load uploaded images from http://localhost:9000/emotial/... (path-style), not from the Docker hostname.

NEXT_PUBLIC_API_BASE_URL is set when the web image is built. If you change the public API URL, rebuild web.

Production notes

On a public host, change these in the compose file (or whatever you use to run it) before you go live:

  • EMOTIAL_SERVER_ALLOW_ORIGINS and EMOTIAL_SERVER_APP_URL to https://your-domain
  • Web build args NEXT_PUBLIC_APP_URL and NEXT_PUBLIC_API_BASE_URL to those public URLs
  • EMOTIAL_AUTH_JWT_SECRET to a new value (openssl rand -hex 32)
  • EMOTIAL_AUTH_SECURE_COOKIES to true
  • EMOTIAL_MEDIA_PUBLIC_URL to the URL browsers use for objects (a CDN origin, or the published MinIO host)
  • Postgres and MinIO passwords

The API image build compiles with libvips (HEIF/AVIF) and runs the media tests during docker build.

Emotial functional specification

Team: $100K MRR (Nathan Lodge, Slater Leonardo)

What the live product does. How it is built is in the technical specification. Site: emotial.app.

Purpose

Emotial is a social site for sharing thoughts and feelings. Reactions are emoji, not a single like. We built it for students and anyone who wants a small, familiar feed.

Actors

ActorCan
GuestRead the feed, explore, and profiles. Sign up or log in. Change theme. Cannot post, react, follow, reply, or report.
UserEverything a guest can, plus write and manage their own posts, react, follow, share, reply, upload media, and get notifications.
AdminEverything a user can, plus review reports and close accounts or delete posts.

Accounts

Sign up: display name, username, email, password. There is no email confirmation. Username is 3-16 characters (letters, numbers, underscore), stored lowercase. Password is at least 8 characters.

Log in with email or username plus password. Log out from the sidebar.

Settings: email, password, theme / accent. Closing the account needs the current password. That retires the username for good and frees the email.

Username does not change after sign up. Display name and bio do.

Posts

A post has a body (up to 500 characters) and optional media.

You can create, edit, and delete your own posts. A deleted post stays in a thread as a tombstone (no author, no body).

You can reply (one hop on a profile; the full thread is on the post page) and share (outbound only). @username notifies that user. #tag is searchable.

Media: up to 4 images (including GIFs) or 1 video. Upload finishes in the background, then the files attach to the post.

The body can include emoji and ordinary links.

Reactions

A user puts one emoji reaction on a post. It is not a like count. They can change it or take it off. Anyone can open the list of who reacted.

Feed sorts: recent, trending, and by emotion (funniest, saddest, maddest, shocking).

People

Follow and unfollow. See followers, following, and friends (mutual follows).

A profile shows avatar (can be animated), banner, display name, username, bio, posts, and replies.

You can report a post or a profile for harassment, spam, or inappropriate content.

Feed, explore, notifications

Feed (/): posts from the network, with live updates when new posts arrive.

Explore (/explore): search posts and people. Recent searches are kept.

Notifications: reaction on your post, reply, follow, mention. Unread count updates live. You can mark one or all read.

Admin

List profiles. List reports and resolve them. Close an account or delete a post.

Guest vs signed-in

SurfaceGuestUser
Feed / Explore / ProfileYesYes
Composer, react, follow, reply, share, reportPrompt to log inYes
Notifications / SettingsRedirect to log inYes
AdminNoAdmin only

Not in this build

Password reset email, Google OAuth, bot accounts, follower badges, and Socket.io were in the proposal and did not ship. Live updates use server-sent events.

Emotial technical specification

Team: $100K MRR (Nathan Lodge, Slater Leonardo)

This is how the live site at emotial.app is built. What users can do is in the functional specification.

Overview

Emotial is a social web app, mostly text. Guests can read the feed and profiles. Users can post, reply, react with emoji, follow people, and get live notifications. Images, GIFs, and video go in MinIO. Production is four Docker containers on one machine: web, API, Postgres, and MinIO.

Architecture

Browser (Next.js)
    |  HTTPS + cookie
    v
Web  :3000          API  :8080
                    |           \
                    v            v
               Postgres        MinIO (S3)

The browser calls the API directly (credentials: include). CORS allows the web origin.

The session is a JWT in an HttpOnly cookie named emotial_sess. If a client cannot store cookies, it can send Authorization: Bearer.

Live feed and notification updates are server-sent events, not WebSockets. The proposal listed Socket.io. We shipped SSE instead.

Huma builds an OpenAPI document from the Go handlers. The web app generates its TypeScript client and TanStack Query options from that document with pnpm openapi-ts.

On the API, a request goes handler to service to GORM to Postgres.

Stack

LayerChoice
WebNext.js 16, React 19, TypeScript, Tailwind CSS 4
Data on the clientTanStack Query, generated OpenAPI SDK, Zod
APIGo, Gin, Huma v2
ORMGORM
DatabasePostgreSQL 16 (citext, pgcrypto)
MediaMinIO (S3 API), processed in-process with libvips
AuthJWT, bcrypt, cookie
Live updatesSSE (/feed/stream, /notifications/stream)
DeployDocker Compose: web, api, postgres, minio

Data model

The schema is source/schema.sql. The API does not create tables when it starts. Apply that file with psql.

Clients do not see numeric row ids. A user is named by username (lowercase, 3-16 characters, [A-Za-z0-9_]). A post is named by a 12-character public id. Internal bigserial ids stay on the server for joins and cursors.

TableRole
usersAccount and profile. Soft delete. Email and username are citext.
retired_usernamesUsernames from closed accounts. Never reused.
postsBody (max 500), optional reply parent, soft delete and edited flags.
post_mediaUp to 4 images (including GIF) or 1 video, ordered by position.
reactionsOne emoji reaction per user per post.
sharesOutbound share. Rows are not updated or removed.
followsFollower / followee pair.
hashtags / post_hashtagsTags parsed from the body.
notificationsReaction, reply, follow, mention.
reportsPost or profile. An admin resolves them.

Diagram: wiki ERD.

If someone closes an account, the email is released and the username is retired. That author's posts become tombstones: no author and no body. Mentions written before the close cannot land on a new person who picks the same name.

API

The API process serves OpenAPI. Routes are grouped like this:

AreaRoutes
HealthGET /health (200 if Postgres answers)
Auth/auth/register, /auth/login, /auth/logout, /auth/me, email / password / close account
Users/users/{username}, posts, replies, followers, following, friends, follow, report, /me, /suggestions
Posts/feed, /posts, /posts/{id}, thread, reaction, reactions, share, report
MediaPOST /media (upload first, then attach ids on the post)
Search/search
Notificationslist, unread count, mark read, /notifications/stream
Feed live/feed/stream
Adminprofiles, close account, reports

Feed sort query: recent, trending, top, funniest, saddest, maddest, shocking.

Auth

Sign up needs display name, username, email, and a password (8 to 72 characters; bcrypt). Log in accepts email or username. Username is stored lowercase.

The JWT secret (EMOTIAL_AUTH_JWT_SECRET) has to be at least 32 characters. The cookie is HttpOnly. In production, Secure is on.

/auth/me is how the web app decides Guest vs User. If that response fails to parse, the app treats the visitor as a Guest.

Media

Upload is its own request. The composer uploads in the background. Creating a post only sends media ids.

Images (including GIF, HEIC, and AVIF) are normalized with libvips in the API process. Videos are stored as uploaded. Duration is recorded.

Objects live in the emotial bucket. Keys look like prefix/date/random so they are hard to guess. Browsers read public_url/bucket/key (path-style). Production uses a CDN origin (cdn.emotial.app).

If MinIO env is unset, the API still starts. Uploads are off.

Web app

App Router. A guest can open /, /explore, and /profile/{username}. Notifications and settings need a session.

The generated SDK is the HTTP client for documented routes. The cache holds UI shapes. Mutations update the cache first, then sync with the server.

Authored text is limited to Latin letters, everyday punctuation, and emoji. Other scripts are rejected on write so layout bombs do not get stored.

Theme and accent hue are client preferences.

Deployment

See deploy instructions.

ServicePortNotes
web3000NEXT_PUBLIC_API_BASE_URL is set when the image is built
api8080Env config (EMOTIAL_*). Optional config.toml
postgres5432Apply schema.sql once
minio9000 / 9001API creates the bucket when EMOTIAL_MEDIA_ENSURE_BUCKET=true

Production is the same four containers on Slater's server, with public origins, a real JWT secret, secure cookies, and a CDN in front of MinIO.

Not in this build

These were in the original proposal and did not ship:

  • Password reset email / Resend
  • Google OAuth
  • Socket.io
  • Bot accounts / a public developer bot API (the HTTP API is for the app)
  • Follower count badges
